Managing a Complex OOG Move to Regional QLD: Delivering A 6 Metres Tank Without Delay
Result Summary
- Delivered a 5.85m-high OOG tank to regional QLD despite height limits and holiday shutdowns
- Secured NHVR permit and executed fully escorted oversized haulage with specialised lifting
- Avoided up to one month of port delays by pivoting to a transport provider with existing permits
When our client needed to move an oversized brewing tank from Qingdao to Warwick (QLD), the complexity was evident from the outset. Measuring approximately 730cm (L) x 442cm (W) x 430cm (H) and shipped on a flat rack with cradle, the combined cargo height reached 5.85 metres once mounted on a low loader — exceeding standard road limits.
What followed was a highly coordinated, time-critical operation involving regulatory permits, specialised lifting equipment, and the added complication of the Christmas–New Year shutdown period.
The Scope of Works
Upon arrival into the Port of Brisbane just before Christmas, several operational complexities emerged:
- Underhook discharge required to lift the flat rack from the vessel
- Transfer onto a low loader truck for oversized road transport
- Load height calculated at 5.85m, exceeding the standard 5m road threshold
- Movement restricted over the Christmas–New Year period
- Requirement for an NHVR (National Heavy Vehicle Regulator) permit
- Mandatory pilot vehicles (front and rear escorts) for road safety
The NHVR permit is critical for oversized cargo, assessing approved routes to ensure the load avoids low bridges, powerlines, and other infrastructure risks. In this case, permits could not even be applied for until government offices reopened after the New Year period on 5 January, creating the risk of extended port storage and significant cost escalation.
Without intervention, the cargo could have remained stranded at the terminal for weeks, incurring substantial port storage fees and significantly delaying the client’s installation schedule.
The Solution
As soon as the final cargo height was confirmed, it became clear the load could not legally leave the port precinct on the originally accepted route. However, our partners had a strategic advantage — their own depot within the Port of Brisbane licensed to handle cargo up to 6 metres high under existing permits.
Instead of allowing the shipment to sit at the terminal, the team:
- Arranged underhook (specialised equipment) discharge from the vessel

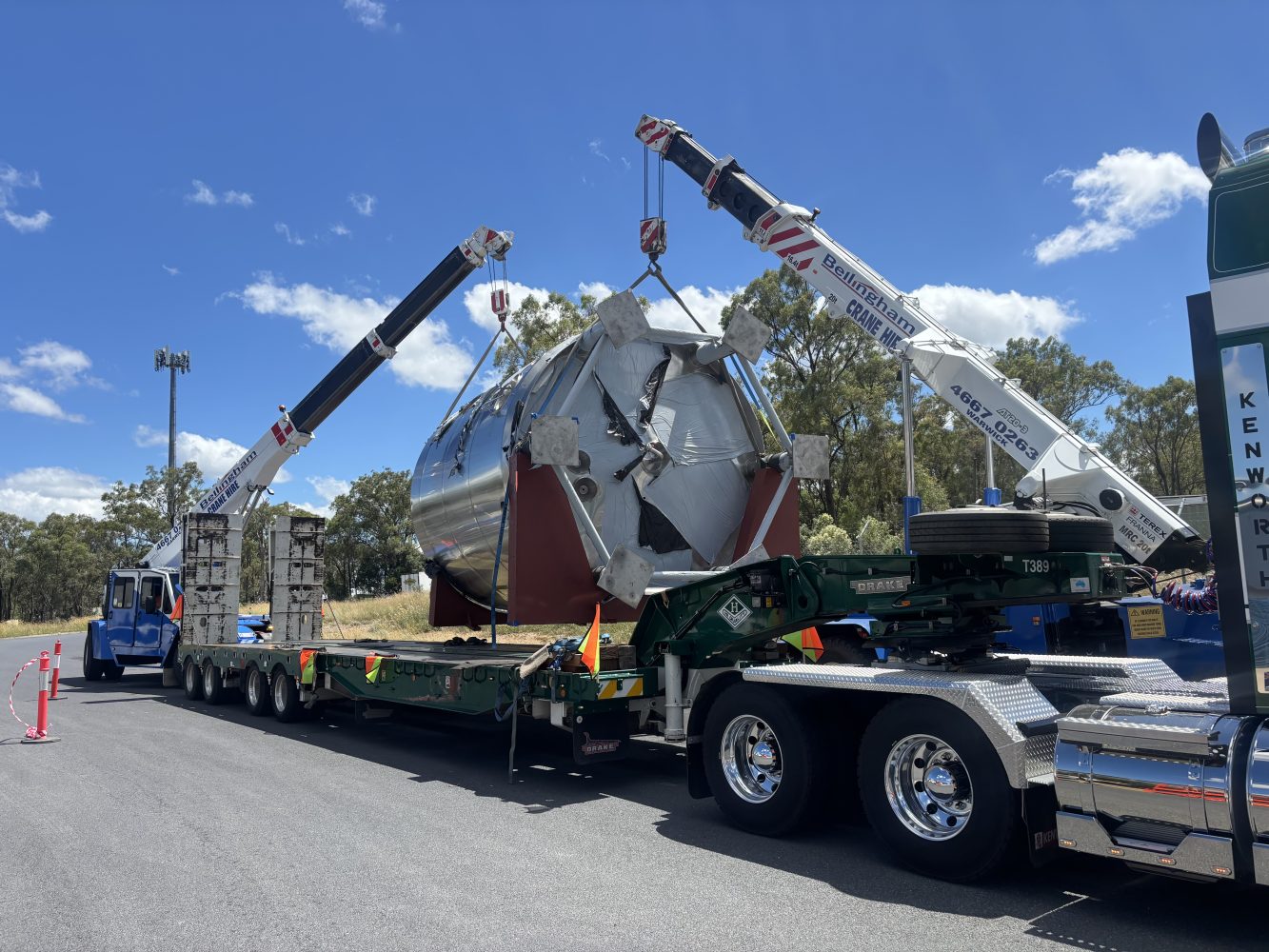

- Loaded the flat rack with the tank onto a low-loader truck via crane
- Diverted the cargo immediately to an approved port-side depot
- Safely offloaded and stored the tank while road transport permits were secured
- Proactively pivoted to an alternative cartage provider that already held the required permit, eliminating what could have been up to a one-month delay waiting for government approval.
- Arranged compliant oversized haulage with two pilot vehicles for final delivery to Warwick
- Concluded the delivery from port to client site within less than a week, avoiding high storage charges.
This rapid pivot bought critical time. Instead of facing a potential one-month delay while waiting for permit approvals after government offices reopened post-holiday, the delivery was completed within the same week.
The Result
Despite late dimension changes from origin (as the shipment was handled offshore prior to arrival in Australia), we worked closely with our trusted partners to:
- Coordinated all specialised handling equipment required — including underhook discharge, cranes, low loader truck and pilot vehicles
- Managed last-minute dimension discrepancies, pivoting quickly to accommodate the revised height requirements
- Secured compliant road approvals fast by engaging an alternative transport provider already licensed for loads up to 6 metres high
- Avoided potentially crippling port storage fees and what could have been a month-long delay
What had the potential to become a costly, month-long disruption was instead a compliant delivery within days. We kept the client informed at every stage, being upfront about the regulations, timing and any extra costs. The Christmas shutdown added pressure, but we stayed proactive, worked closely with our partners, and kept solutions moving.
Out-of-gauge cargo isn’t just about size — it’s about timing, regulation, equipment, and contingency planning. And that’s why at ICE “We Consult. We Plan. We Deliver”.
